Prins Maurits Retrofit

This project was done by our partner, Team Maritime in corporation with Høglund, while the ship was anchored outside Cadiz, June 2016.

Vessel Information:
Built: 1997
Owner: GC Rieber shipping
Segment: LPG Carrier

This project was done by our partner, Team Maritime in corporation with HMA, while the ship was anchored outside Cadiz, June 2016.

Time spent: 6 days from start of reconnection, to DNV approval.

The system consist of:

  • Integrated Machinery Alarm system
  • GMR Playback
  • Høglund Remote Control, for remote service and support

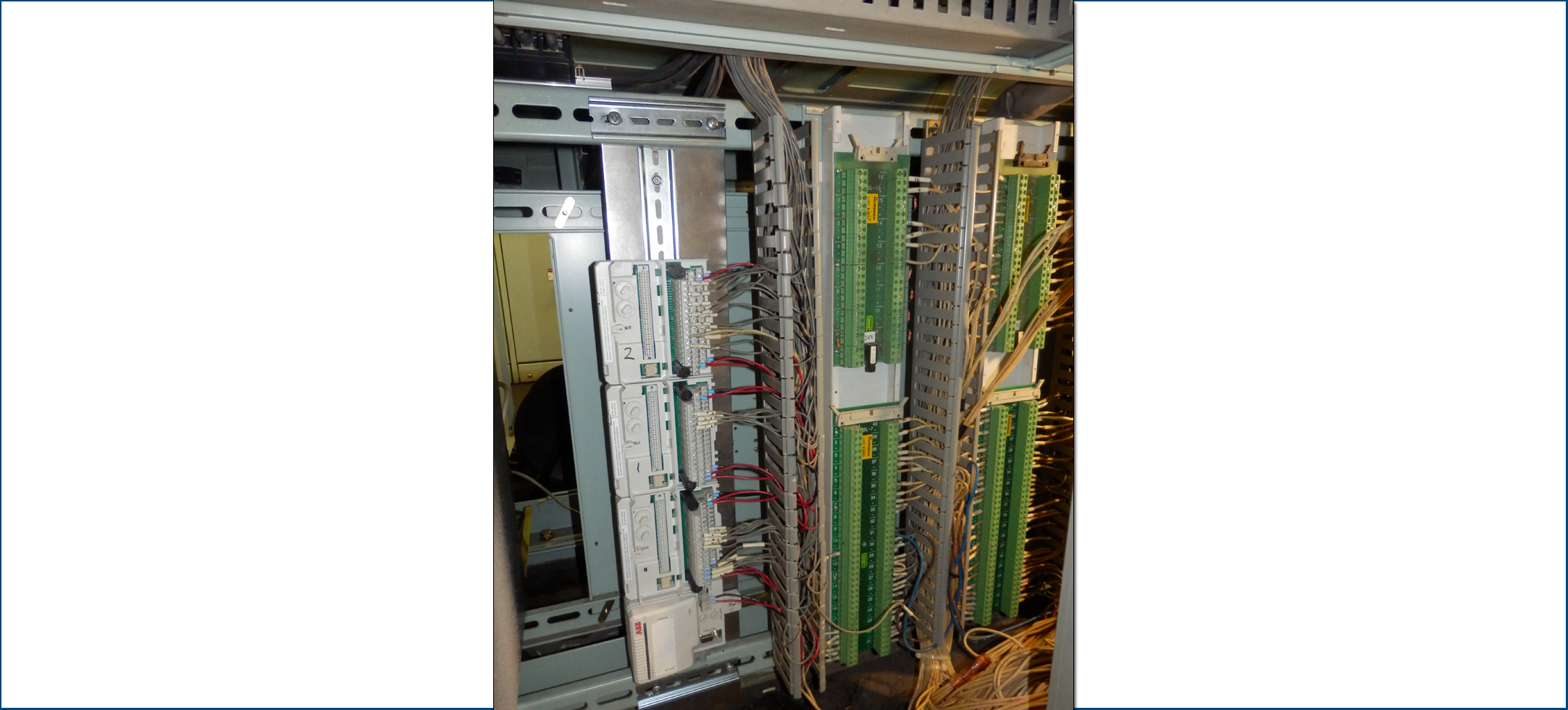

I/O Cabinet before upgrade

Before Upgrade

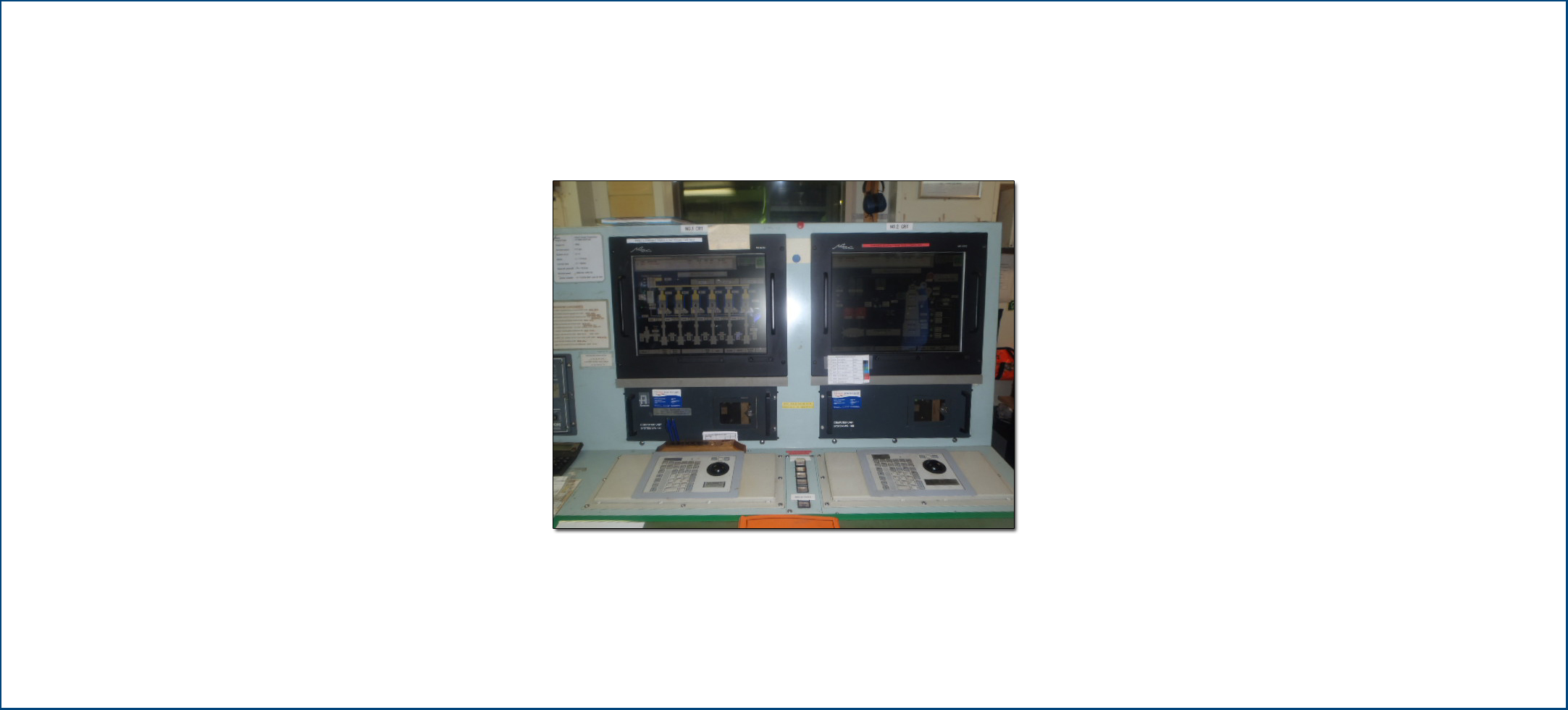

ECR-Desk before upgrade

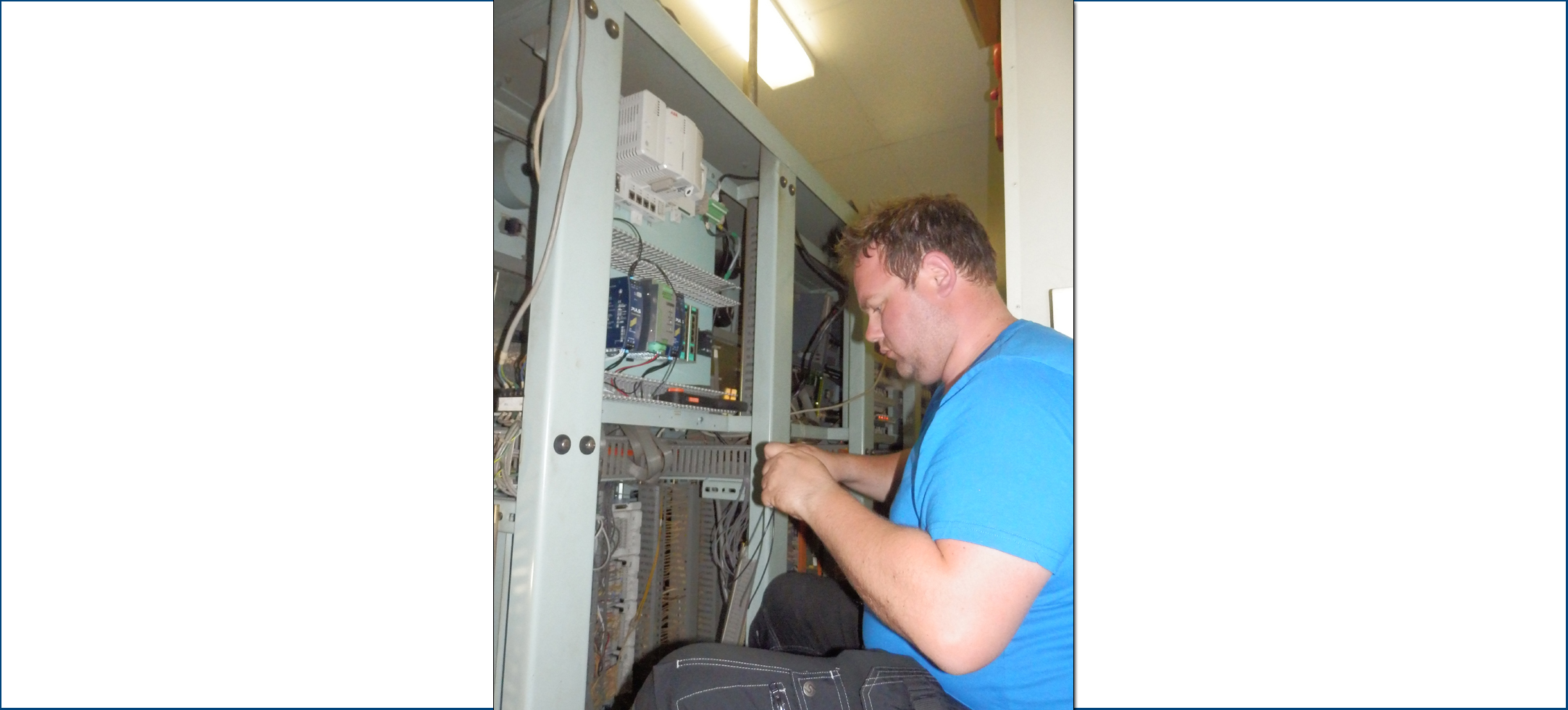

Bjørn Klokhaug, Team maritime during reconnection

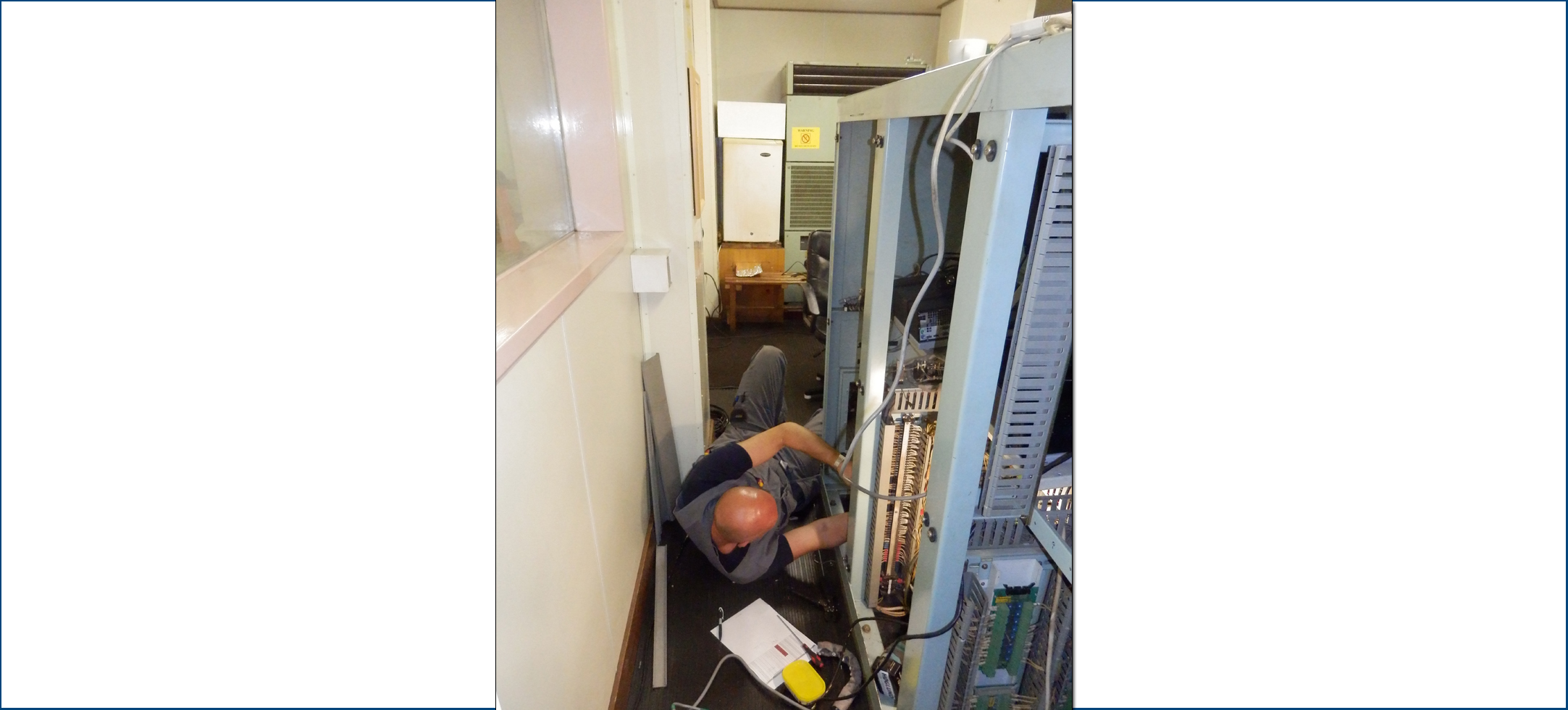

Høglund is replacing old system

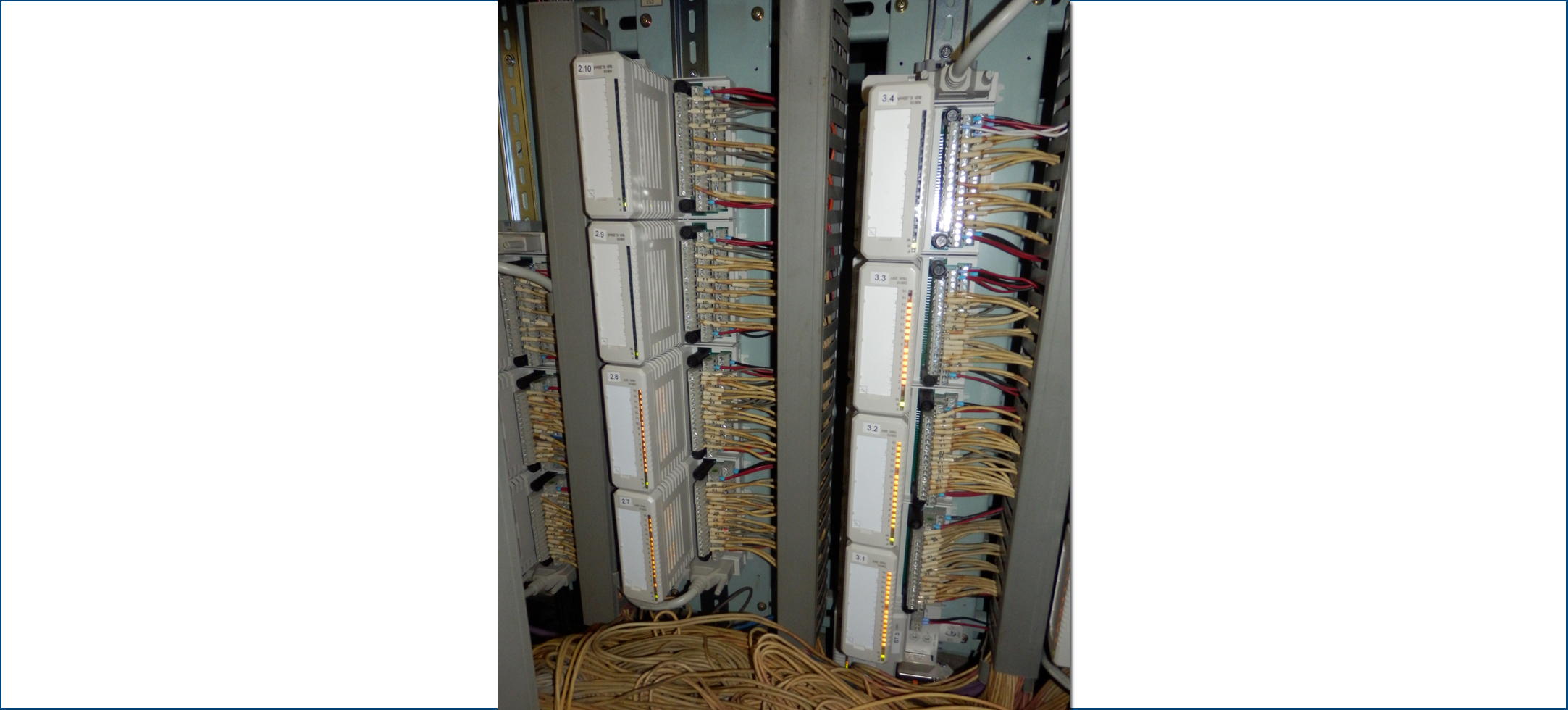

I/O Cabinet after upgrade

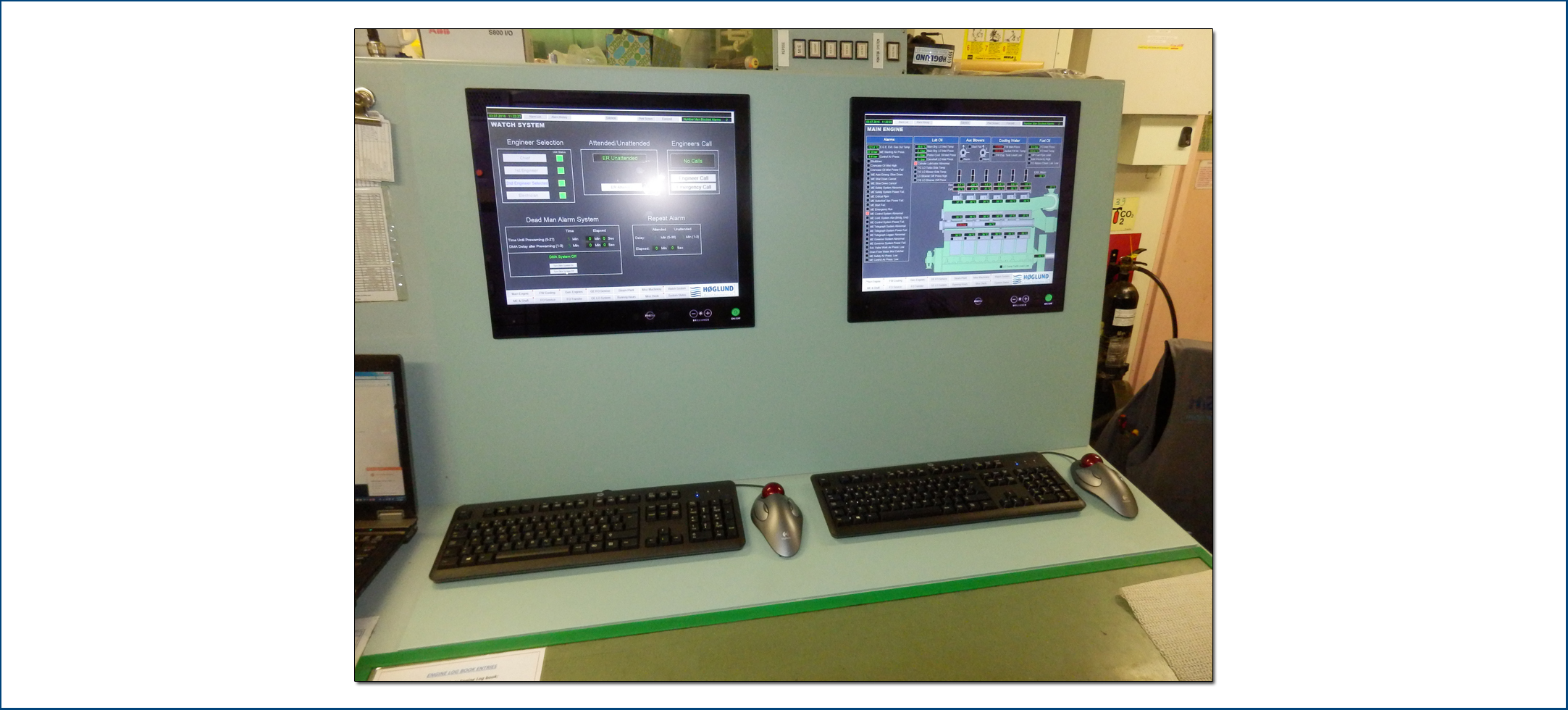

New operation stations after upgrade


This was a “turn-key” contract. Høglund project and commissioning engineers arranged :

  • Approbation with Factory Acceptance Test together with DNV-GL
  • Installation, Re-connection and I/O check
  • Harbour Acceptance Test with DNV-GL

After the sea-trial we handed over the new system with all approved certificates needed.
